Pages

Saturday, 29 September 2012

More roof truss work.

Yesterday saw more roof truss work and delivery of the steel support beams for above the alfresco doors and above the front portico.
We probably wont see any more action until Tuesday due to the long weekend.





Support Beams:

Steel support for Alfresco Beam:

Alfresco door frame:

Thursday, 27 September 2012

Roof trusses started.

Our roof trusses were started today. A crane rocked up to lift the support beams for the Alfresco and garage and then the actual trusses.
The trusses seam very fiddly, especially where the rooms arent squared off, and the carpenters spent most of the day on the back section of the house.

Our windows, sliding doors and door frames were also delivered today.







Front and laundry door frames

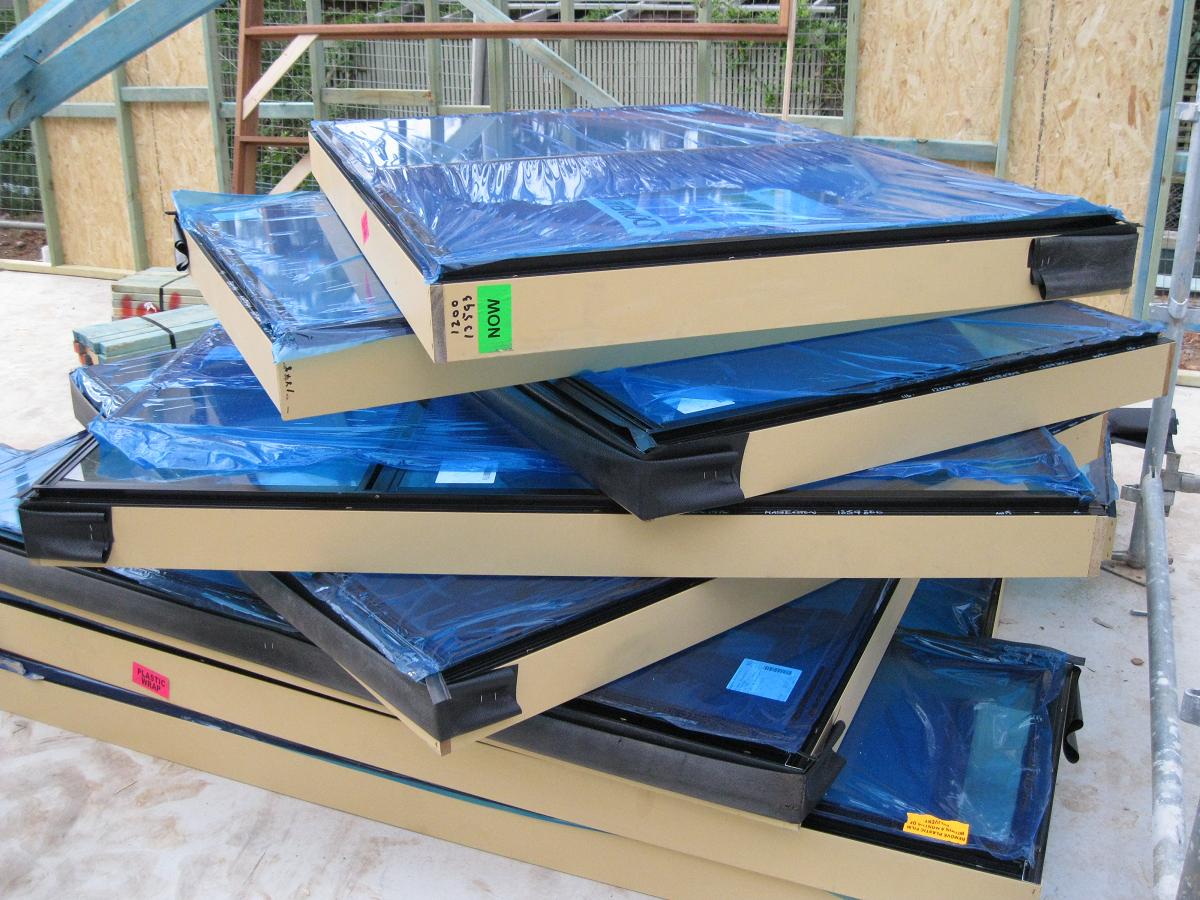

Windows:

Alfresco stacker doors:

Wednesday, 26 September 2012

Frames up

Our frames were 99% completed today. The carpenters left a lot of gear here so I dare say they will be back tomorrow (weather pending) to finish of the frames and hopefully knock the trusses over.

I cant describe how excited we feel. We had a decent walkthrough after they had left and could finally truly visualise what we will have. Its quite breathtaking and makes all the planning, organising and waiting, well and truly worth it. :)

Also, we chose the 2.7m ceilings and man they are big. I feel like an ant standing next to the frames.








Towards garage:

Towards front entry:

Front entry:


From home theatre to kitchen:

Tuesday, 25 September 2012

Scaffolding started

A bit of a slow day today for us. We had a scaffy turn up and install part of the scaffolding for the Beams for the garage/alfresco.
Unfortunately the frames were placed in his way so he couldnt finish what had to be done. Also had the recess box for the gas hot water system dropped off. Hopefully see some carpenters here tomorrow.


Heres a few more pics:







Monday, 24 September 2012

Frames & Trusses delivered

Our frames and Trusses were delivered this afternoon at around 4:30pm. I actually didnt think they would arrive but sure enough. Now we wait for the carpenters.









Wednesday, 19 September 2012

External plumbing done.

The plumbers were back today and have completed the external drainage and tapped in to the septic tank.
All the ground stuff is now done and the only way is up. Frame delivery and erection next. Cant wait.





Tuesday, 18 September 2012

Tank delivered


Heres some more pics of the slab all nice and dry. Expecting the plumbers tomorrow and hopefully frame delivery this week?
The first progress payment was also made yesterday. Masterton didnt muck around. They had the invoice in the post the same day the slab was poured. Thats fine because I didnt muck around either. The payment was made within 1 hour of receiving the invoice.




We also had our 10K Litre water tank delivered today.







Friday, 14 September 2012

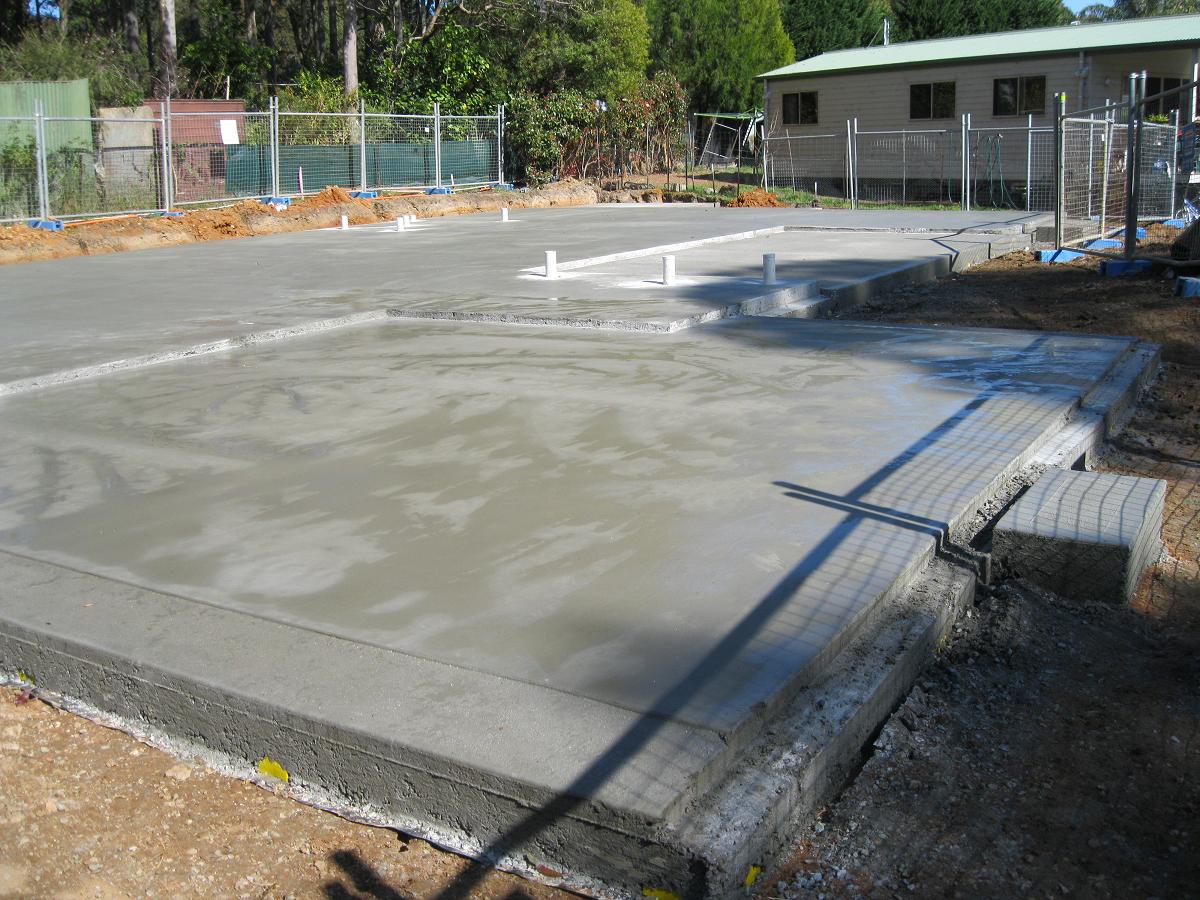

We have a slab!

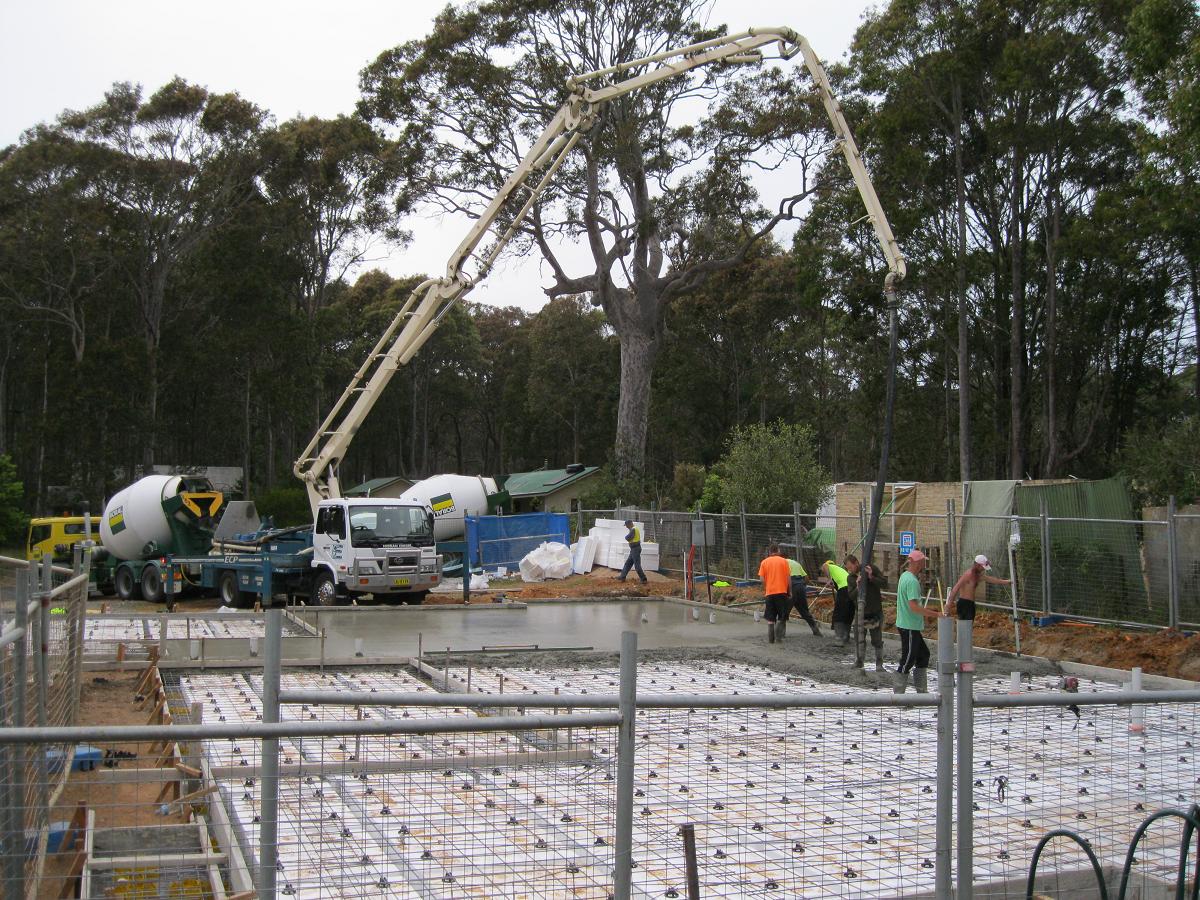

Our slab was poured yesterday. The concretors started at around 6:30am and the slab was poured by 10:30am. Just as they finished pouring it started raining which delayed the finishing off by about an hour. The concretors did a great job and were super fast and efficient without affecting quality.

We also counted 9 truckloads of concrete at around 50 cubic metres!

Pics from yesterday:











Pics from today:
